5th December 2024 - Hinkley Connection news
2 min read
On Horsey Levels north of Bridgwater, the Hinkley Connection team have been undertaking complex engineering works to modify the electricity network and connect in the southern-most T-pylons on the route.
Construction activity, which began in 2019 has included:
This work was needed to connect the southernmost T-pylons on the Hinkley Connection, which run from Horsey to the Huntspill River, onto the electricity network.
To achieve the connection, the two circuits on the T-pylons needed to turn in and one had to cross over the existing Shurton to Bridgwater electricity line. For many reasons, including safety, overhead lines should not cross over each other, so that section of the route was undergrounded.
Once energised, the section of T-pylons will complete a new circuit running between Hinkley and Melksham and provide greater resilience across the network.

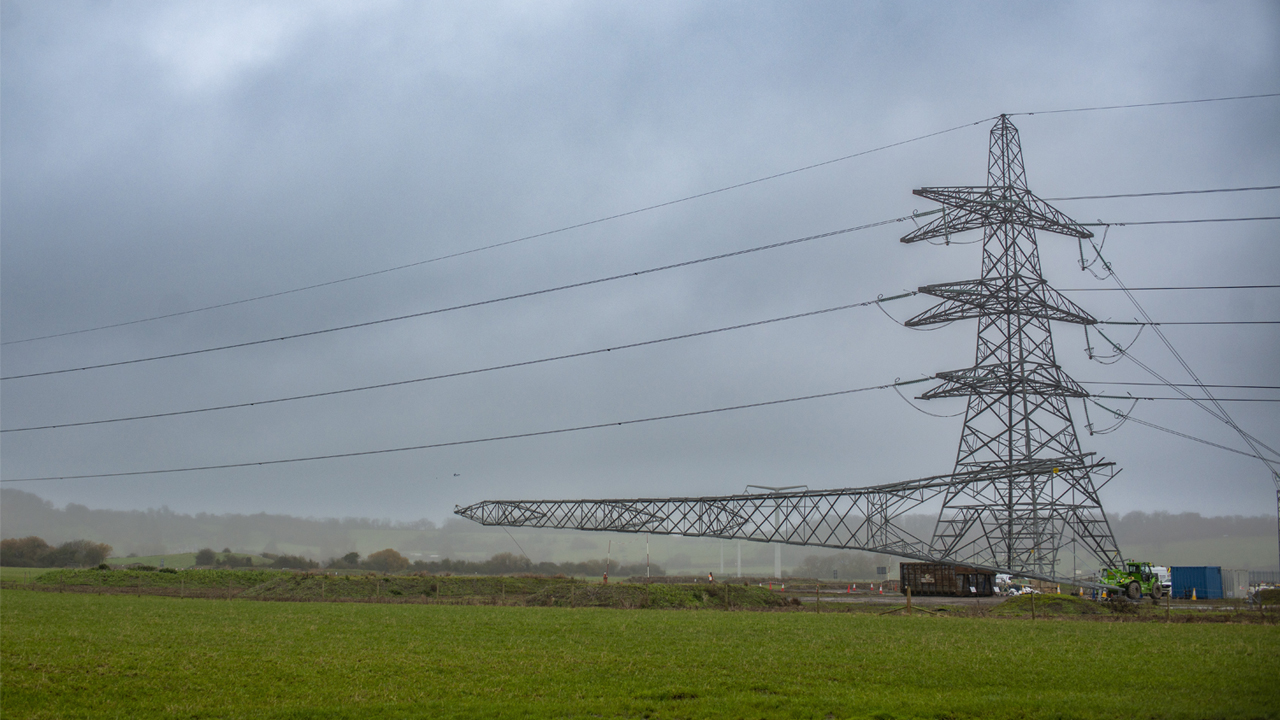

The removal of the temporary pylons on 29 November and 1 December, construction works are almost complete, with the final stages set to finish by Spring 2025 and the T-pylons in this area energised in the Summer.
